Runway 1-19 Rehabilitation Project – Summer/Fall 2026

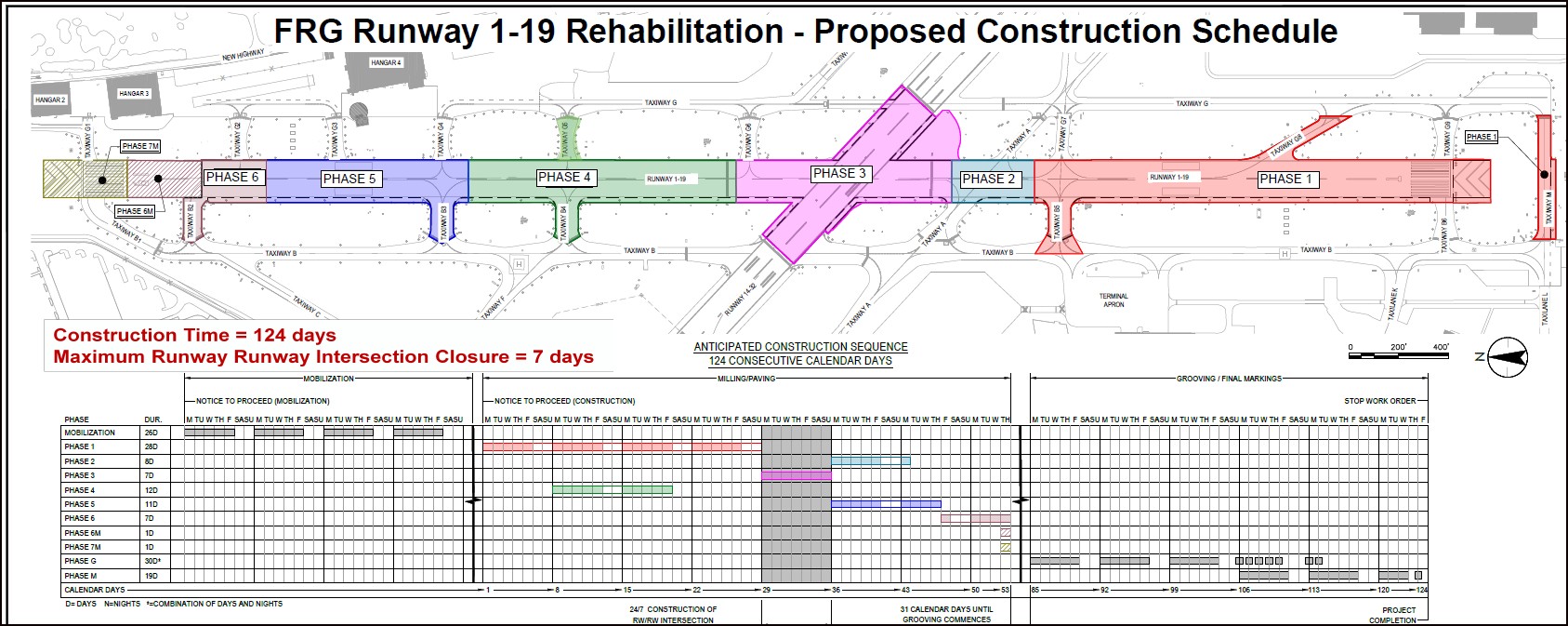

The anticipated project phasing is shown below.  Check NOTAMS for updated closure times and dates.

October 19, 2026 Update:                                                                                   Click on above image to enlarge

  • October 5, 2026 – Pavement Grooving began in Phase I (orange area) and will continue from south to north.  Phase 4, 5, 6, 2, and 3 will follow in order each was paved.  The estimated time is 5 weeks.
  • Airport Closure Dates:
    • Oct 20,2026 – 12:00 am to 4:00am for runway lighting repairs.
    • Nov 1-8, 2026  – 10:00 pm to 7:00am for pavement grooving in Phases 2 and 3

Please note dates and times subject to change due to weather.
